Selecting between a reinforced concrete raft slab and a traditional deep strip foundation is a pivotal structural design choice that determines a project’s early-stage budget and groundworks timeline. While deep strip foundations have long served as the baseline for low-rise developments, changing soil conditions and volatile muck-away costs mean they are often no longer the most economical solution.
The right choice starts with the site investigation. Bearing capacity, soil type, trees, groundwater and the depth of any Made Ground all point towards one system or the other, usually before anyone has priced a trench.
Technical Mechanics: How Load Transfer Mechanisms Differ
To properly evaluate structural viability, engineering teams must look beyond initial excavation costs and analyse how each system interacts with the underlying strata:
Strip foundations: line loads on a narrow footing
Strip and trench-fill foundations carry wall loads down to a narrow band of concrete at founding level. They work well where there’s consistent, competent ground at a reasonable depth. If that ground varies across the footprint, or the trench has to keep going deeper to find it, the risk of differential settlement and the cost both rise quickly.
Engineered Raft Foundations: Raft foundations: load spread across the footprint
A raft is a continuous reinforced concrete slab under the whole building. Because it spreads the load over a much larger area, the bearing pressure on the ground is lower. Its stiffness also helps it bridge local soft spots that would cause problems for a strip.

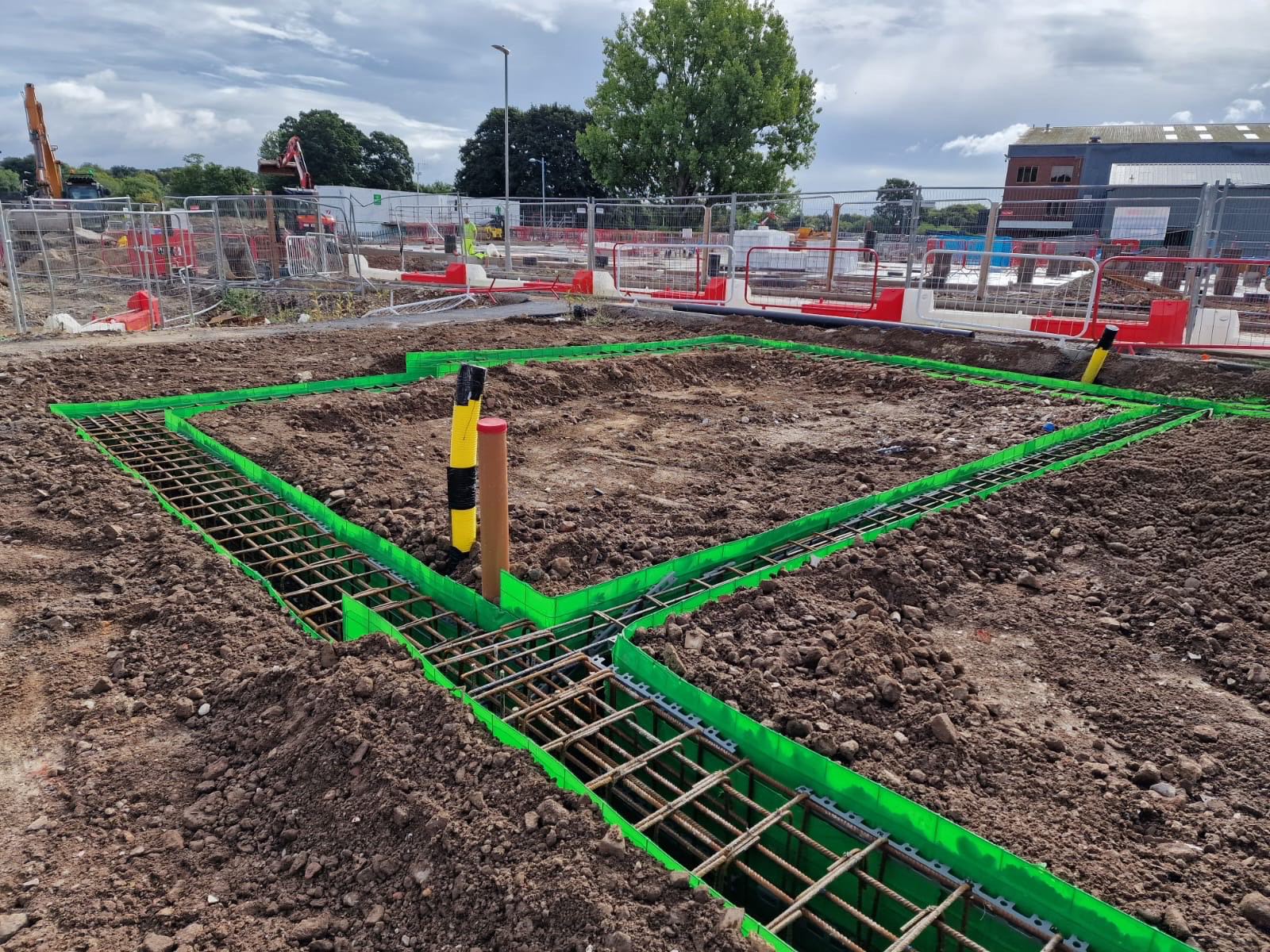

Strip Foundations from SPEEDECK Foundations
Geotechnical selection criteria: when a raft makes more sense
Continuing to specify deep strip foundations on complex sites leads to unpredictable groundworks delays and unexpected budget increases. These are the site conditions where a raft, or a piled raft, usually becomes the better option.
Variable ground and Made Ground
On brownfield sites and old fill, density can change every few metres. A strip transfers each wall load to whatever sits directly beneath it. A raft spreads the load across the footprint, reducing the risk of differential settlement.Shrinkable clay
In clays with medium to high volume change potential, NHBC Chapter 4.2 sets minimum strip depths of 0.9–1.0m to get below seasonal moisture movement. That’s before any trees are taken into account.Trees
Trees are what usually push strips deep. Depending on species, distance and soil plasticity, depths can pass 2.5m, at which point NHBC requires an engineer-designed foundation. Where trees have been removed, the clay can also swell back, so heave protection is needed beneath the foundation.High groundwater
Deep trenches below the water table can need dewatering and become unstable. A raft keeps excavation shallow, which in most cases keeps the works above groundwater. More on foundations for high water tables.When a raft needs piles
If there’s no competent bearing stratum near the surface, for example deep Made Ground, soft alluvium or a heave risk, a ground-bearing raft isn’t enough. A piled raft transfers the structural loads through piles to deeper, stronger ground, with heave protection beneath the slab where needed. How piled rafts work and when they make sense.
On site: Cheshunt Park Farm
At Futura Phase 1 in Cheshunt, the ground was Made Ground over Dollis Hill Gravel and London Clay, with trees scattered across the site. Strips would have meant chasing depth plot by plot. Instead, we delivered 23 rafts across 2,561m² for 24 homes, with full heave protection on the plots within tree influence, on a 12-week foundation programme. Watch the Cheshunt video here.

Ground Bearing Raft Foundations with SPEEDECK Foundations
Structural Efficiency and Cost Comparison Matrix
When assessing the commercial viability of a multi-plot residential or commercial scheme, estimators must evaluate the total impact on follow-on structural trades:
- Excavation and muck-away volumes
-Engineered Raft Foundation – Minimal (Requires only a shallow topsoil strip)
-Traditional Deep Strip Foundation – High (Soil displacement from deep trenching) - Substructure brickwork and flooring
-Engineered Raft Foundation – None (Slab forms the immediate floor deck)
-Traditional Deep Strip Foundation -High (Requires extensive block underbuild & beam/block floors) - Material waste profiles
-Engineered Raft Foundation – Low (Singular, integrated concrete pour)
-Traditional Deep Strip Foundation – High (Prone to over-pouring in unstable trenches) - Groundwater de-watering risk
-Engineered Raft Foundation – Low (shallow excavation only)
-Traditional Deep Strip Foundation – High (High risk of trench flooding)

Piled raft foundations from SPEEDECK Foundations
The Monolithic Efficiency Advantage
Beyond pure concrete volumes, selecting an engineered raft simplifies the construction sequence for follow-on structural framing teams.
Because the finished raft slab serves as both the load-bearing foundation and the immediate, level ground floor deck, it entirely removes the need to schedule subsequent beam-and-block flooring installations or extensive substructure brickwork underbuilds.
By compressing these two distinct construction phases into a single, highly controlled concrete pour, developers regularly cut days off the substructure schedule. This allows framing crews to begin erecting timber, steel, or masonry structures on an organised, high-tolerance working platform immediately.
Every site is different, so the decision should come from the ground, not habit. If you’ve got a site investigation and you’re weighing up foundation options, our engineers can review it and tell you what makes sense.
