Skip to main content
Projects

Fairmile Lane, Cobham: Voided Piled Rafts for 4 Homes in a Tree Influence Zone

  • Client
    Chartridge Developments Ltd
  • Location
    Cobham, Surrey
  • No. of Units
    4 units
  • Residential Properties

Project Overview

Chartridge Developments Ltd is building four homes at Fairmile Lane in Cobham, Surrey, on a site surrounded by mature trees. All four plots sat inside a tree zone of influence on shrinkable clay, so the foundations had to resist heave as well as carry the homes. SPEEDECK designed and built four voided CFA piled rafts covering approximately 790 m², on 300 mm CFA piles, within a six-week programme from the start of piling.

Key Facts:

  • Project: Fairmile Lane, Cobham
  • Client: Chartridge Developments Ltd
  • Location: Cobham, Surrey
  • Number of Units: 4
  • Foundations:4 voided CFA piled rafts, approximately 790 m², on 300 mm piles 7 m to 13 m long
  • Ground: Made Ground over Bagshot Formation sands and shrinkable clays
  • Trees: Every plot inside a tree zone of influence, including mature English oak
  • Programme: Six weeks from the start of piling to handover at slab level
  • 35% concepting
  • 35% detailed design
  • 30% duration on site.
Time Spent Data

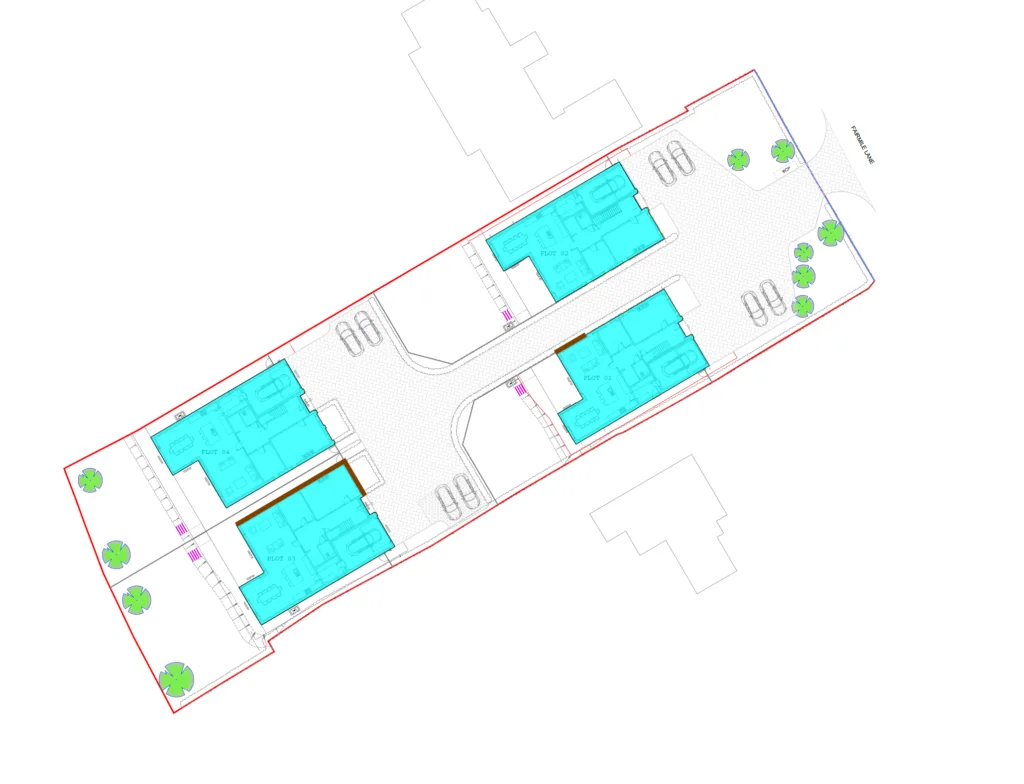

Key plan fairmile lane cobham

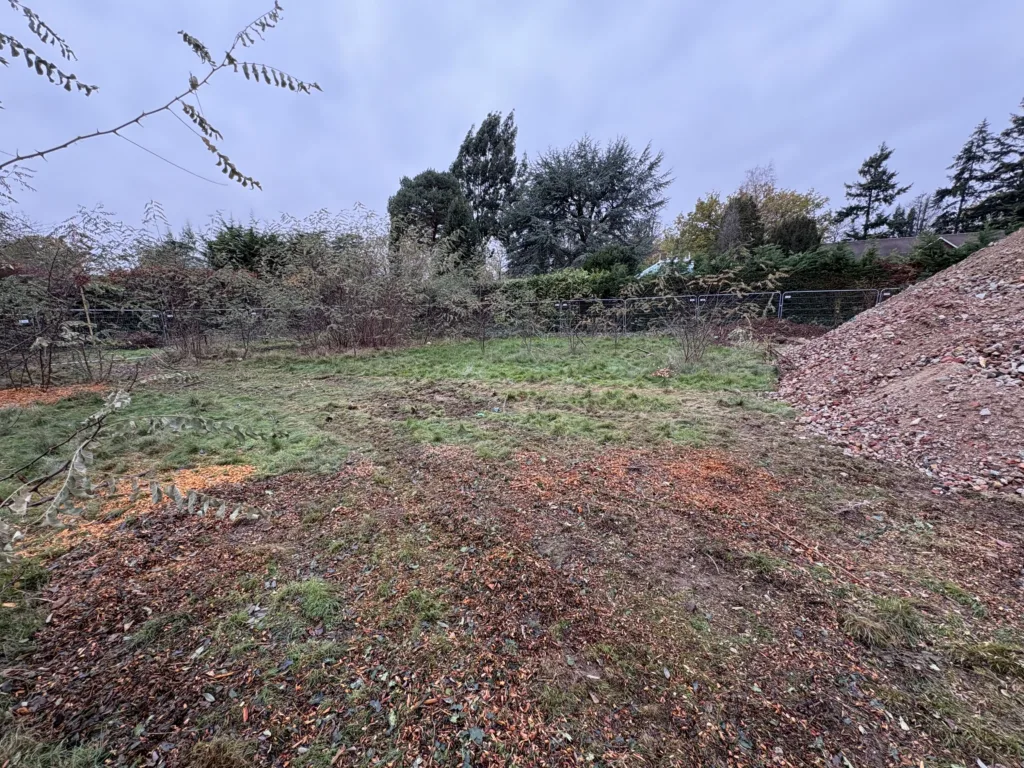

Site start at Fairmile Lane Cobham

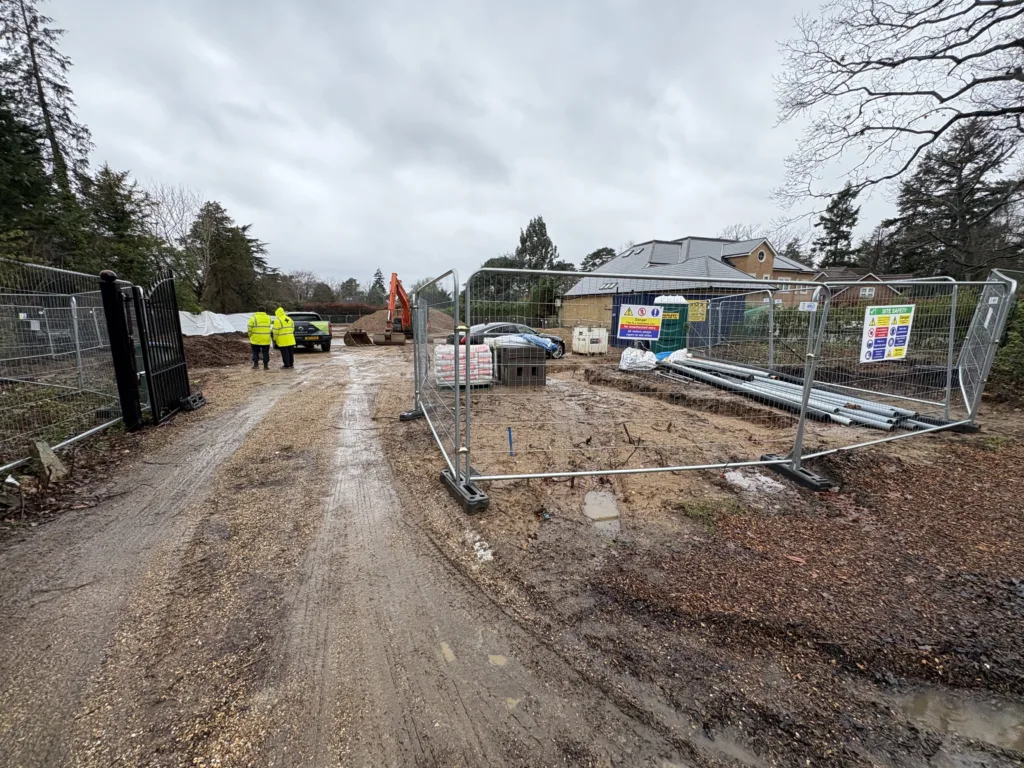

Site entrance at Fairmile Lane with SPEEDECK

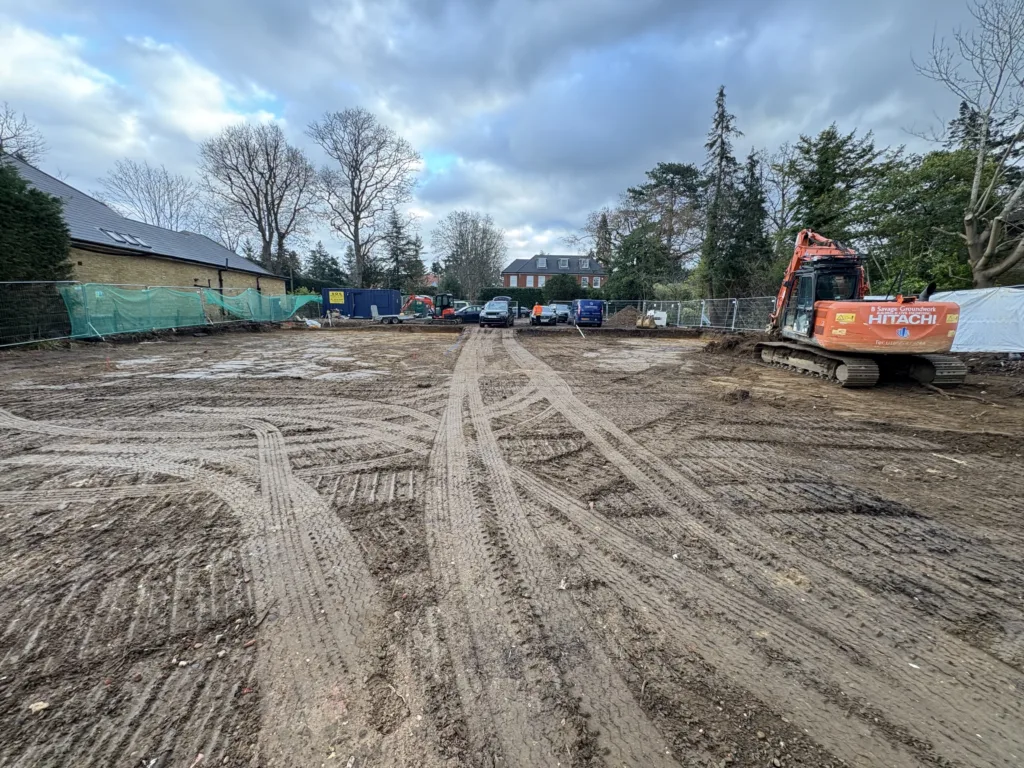

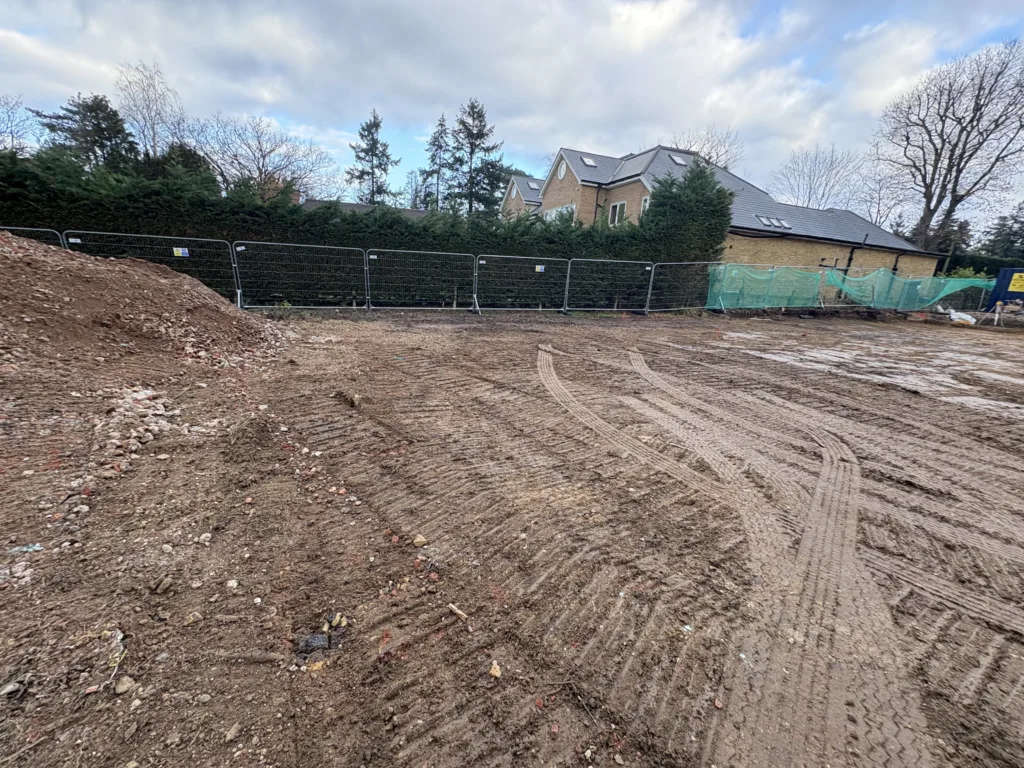

Site ready at Fairmile Lane 2
Site ready at Fairmile Lane

Concept Design

The ground is variable Made Ground, 0.15 m to 0.50 m thick, over the Bagshot Formation: layered sands, gravels and sandy to gravelly clays to at least 20 m. Perched groundwater was found at 0.8 m to 1.0 m below ground level, with deeper groundwater at 14 m.

Clay: The site investigation classed the clay as intermediate to high plasticity (plasticity index 27% to 32%), medium shrinkability under NHBC Standards. SPEEDECK’s Atterberg limit tests showed desiccation in the shallow clays, with low to medium volume change potential in the top 3 m, so heave had to be designed for.

Trees: The NHBC Standards Chapter 4.2 assessment covered 18 trees, groups and hedges, including high water demand English oak and Lawson’s cypress with zones of influence of up to 25 m. Several trees were removed for the scheme, which raises the risk of heave as the clay rehydrates, and the arboricultural assessment identified work within the root protection areas of six retained trees. Every plot fell inside a zone of influence and needed heave precautions.

Options considered: SPEEDECK assessed each foundation type against the ground. Strip, trench-fill and ground bearing rafts would have needed excavations deeper than 3 m to get below the heave zone, which made them highly uneconomical. Ground improvement would not deal with heave, and driven or displacement piles were ruled out by the Made Ground, noise and vibration. A CFA piled raft was the most economical solution, matching the piled solution recommended in the site investigation report.

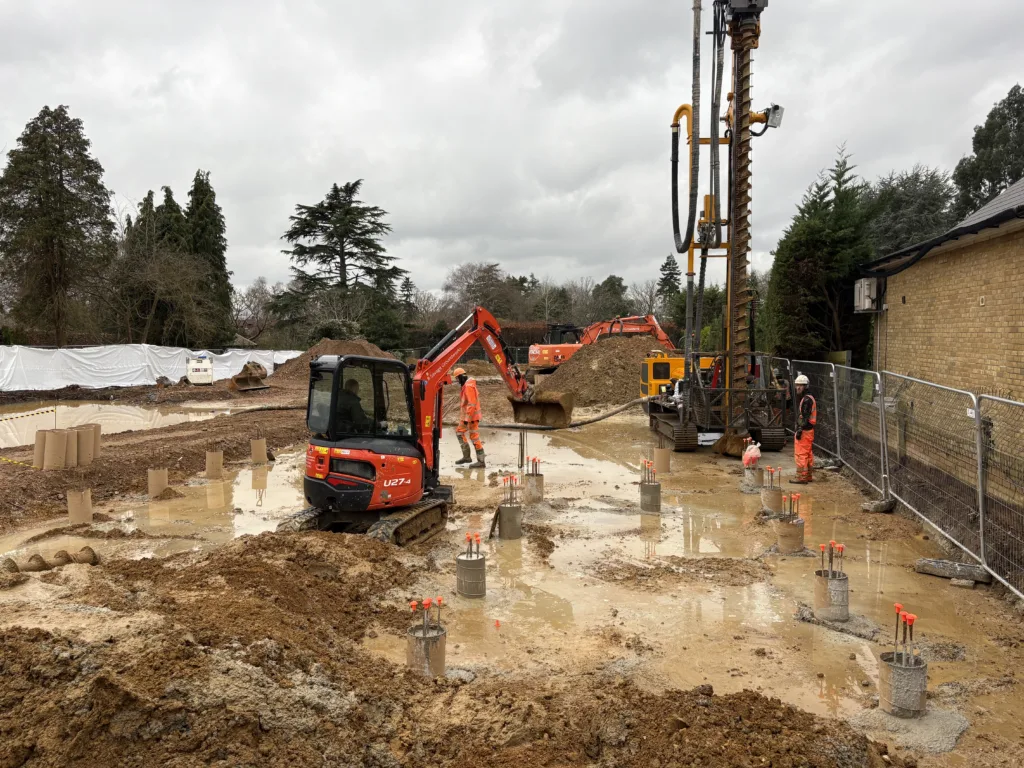

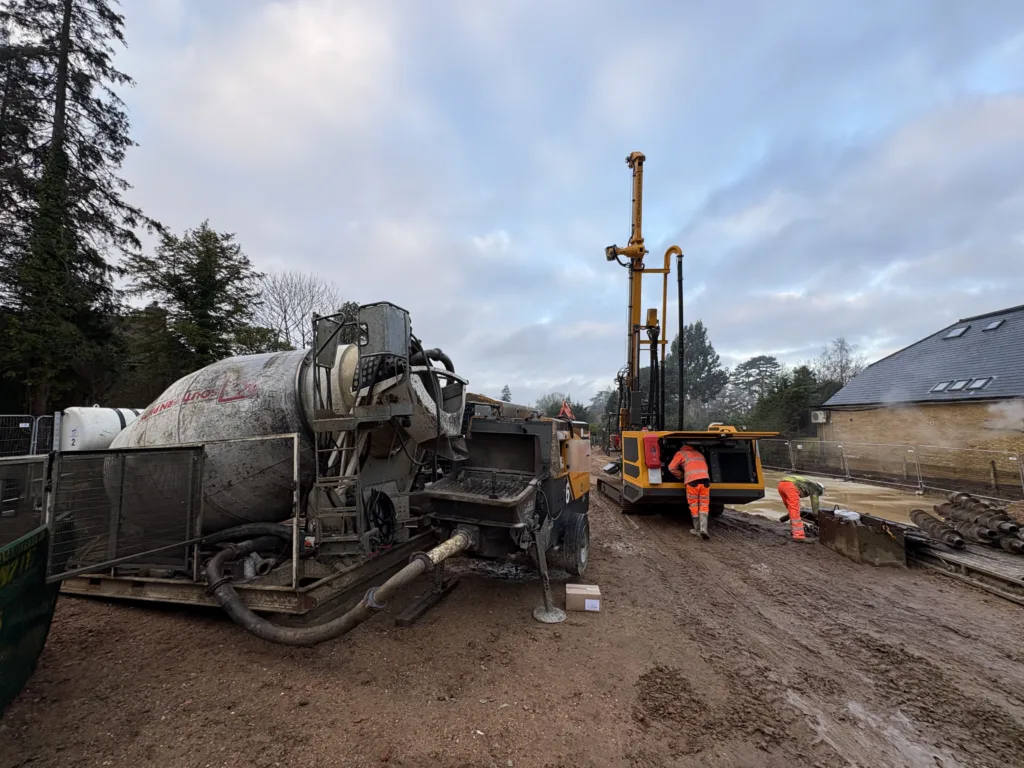

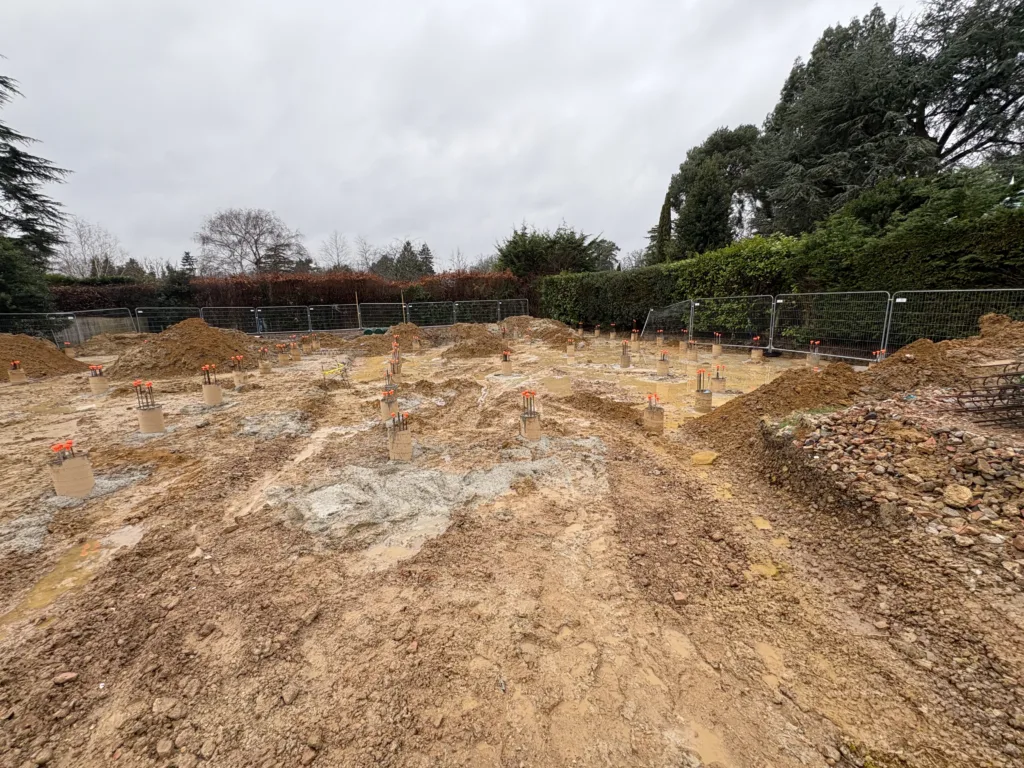

Piling at Fairmile Lane Cobham
Piling at Fairmile Lane with SPEEDECK
Piling with Chartridge Developments

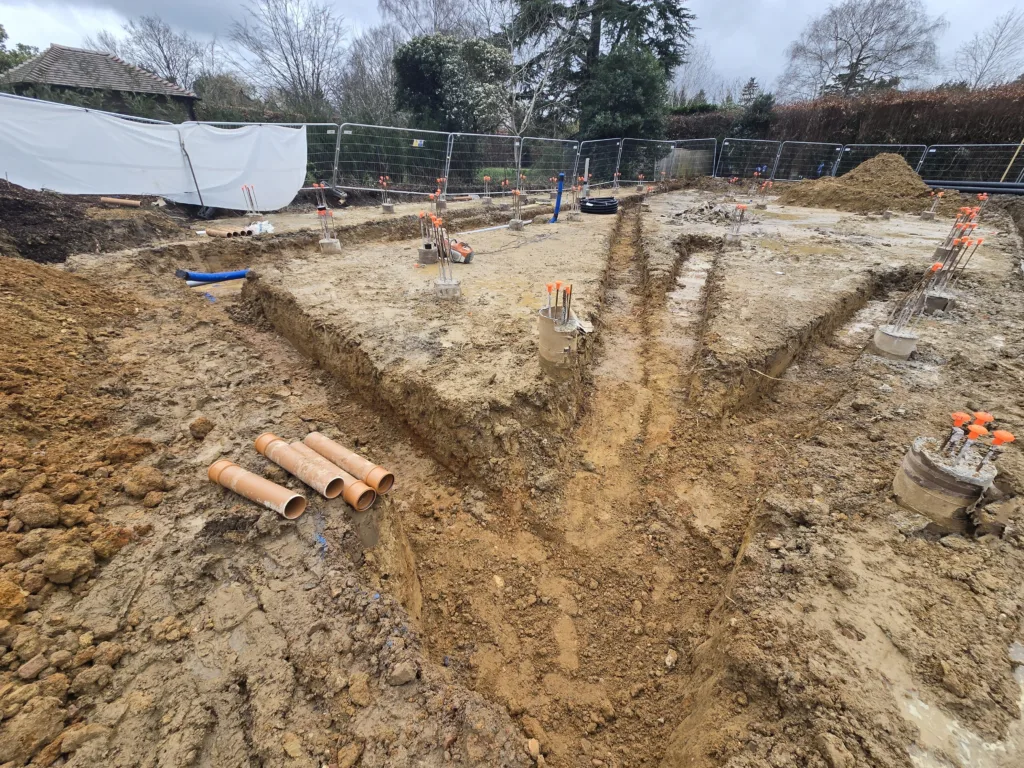

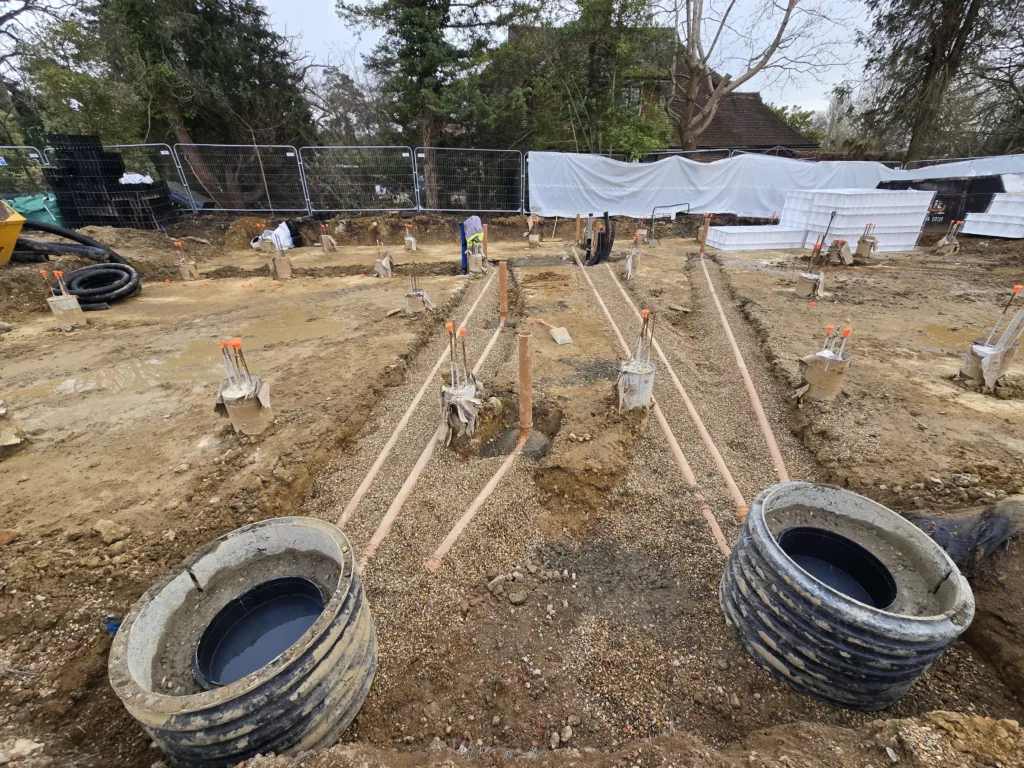

Drainage and services at Cobham
Drainage at Fairmile Lane Cobham

Design Engineering

Each home sits on a 225 mm thick reinforced concrete raft in RC35 concrete, laid over a 160 mm voidformer to absorb clay heave. The rafts are supported on CFA piles, 300 mm in diameter and typically 7 m to 13 m long, with a maximum safe working load of approximately 320 kN.

The top 3 m of soil was ignored when calculating pile capacity, because heave in that zone can pull on the piles rather than support them. Each pile carries heave reinforcement in its upper section to resist those tension forces. The design needed no ground beams or pile caps.

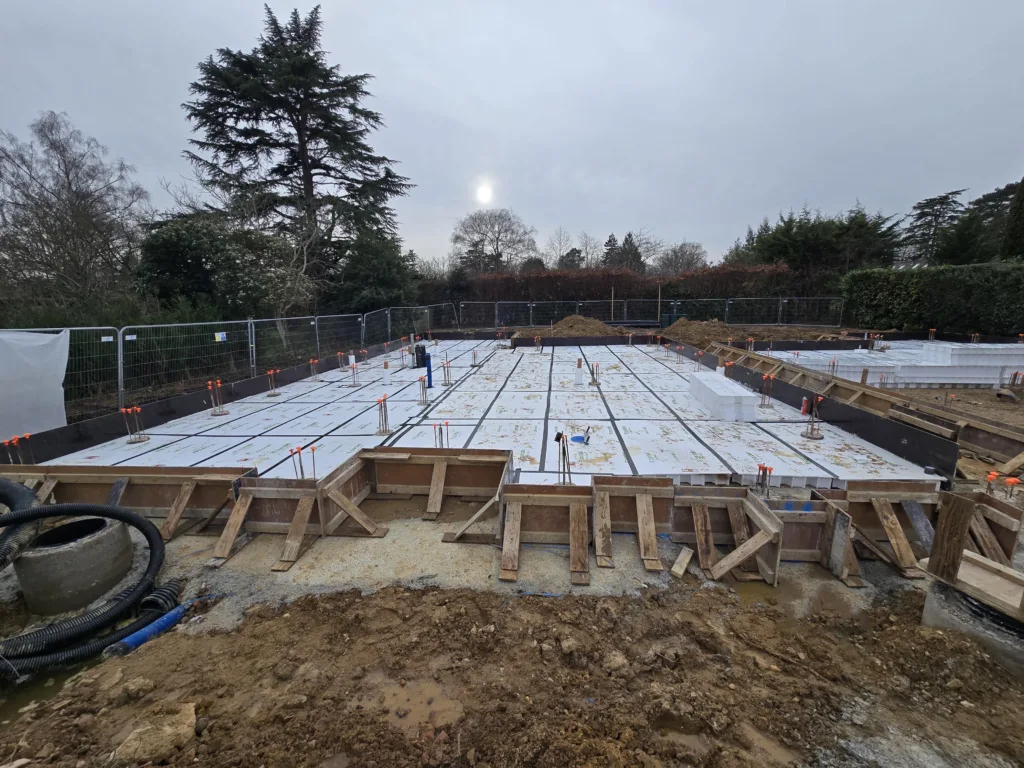

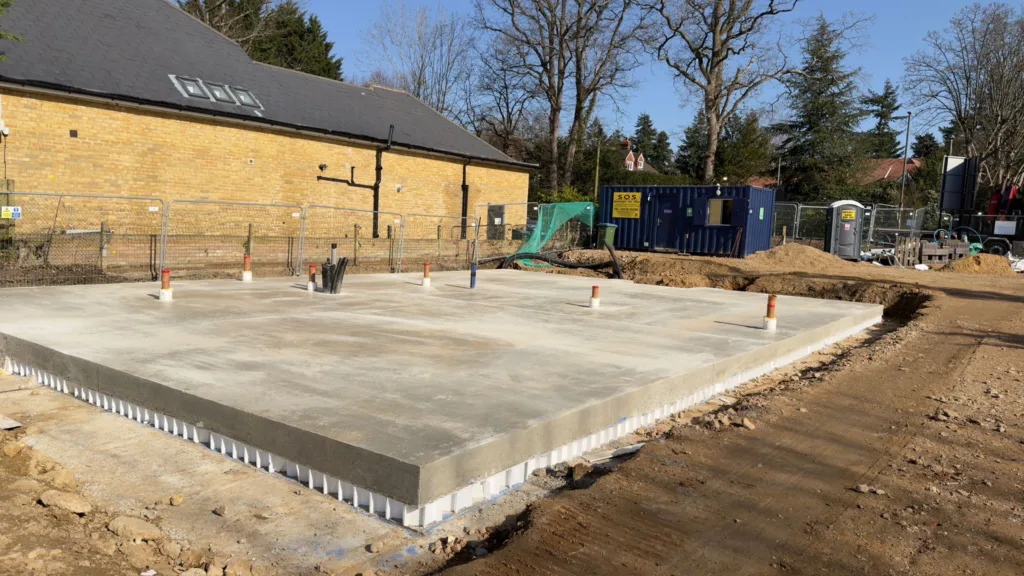

Heave protection from SPEEDECK at Cobham

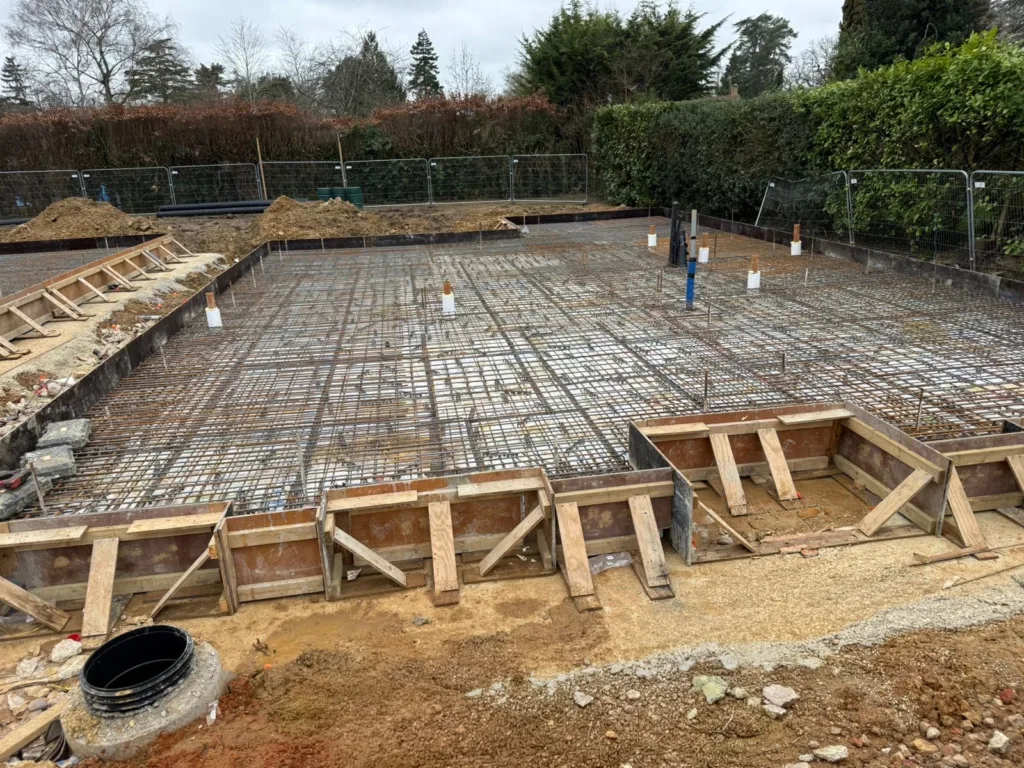

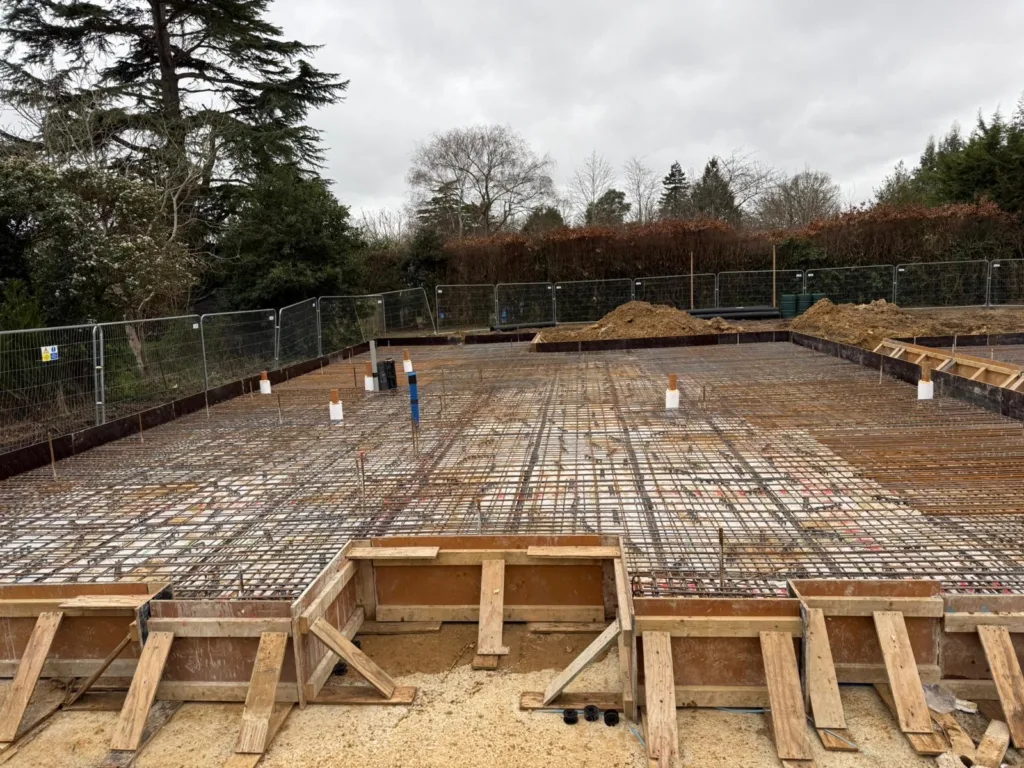

Piled raft foundation construction with SPEEDECK at Cobham

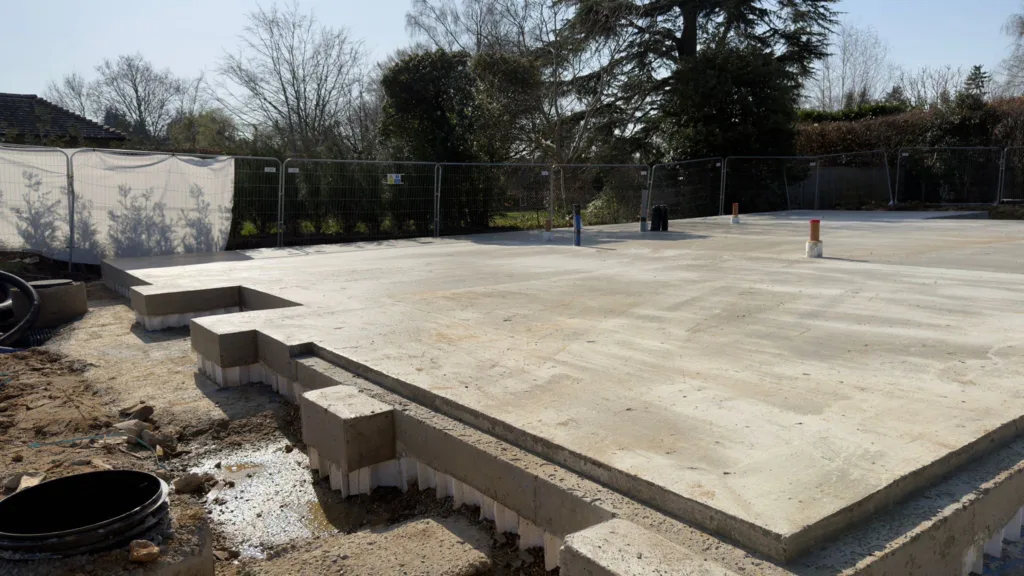

Piled raft foundations at Chartridge Developments

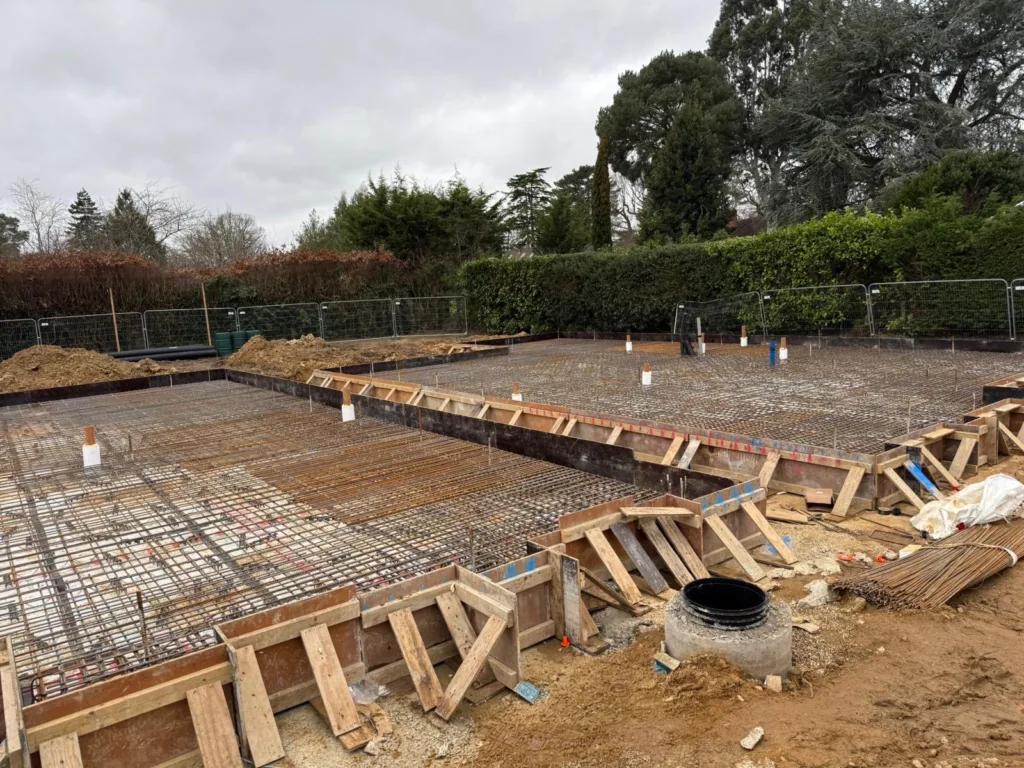

Raft construction from SPEEDECK Foundations

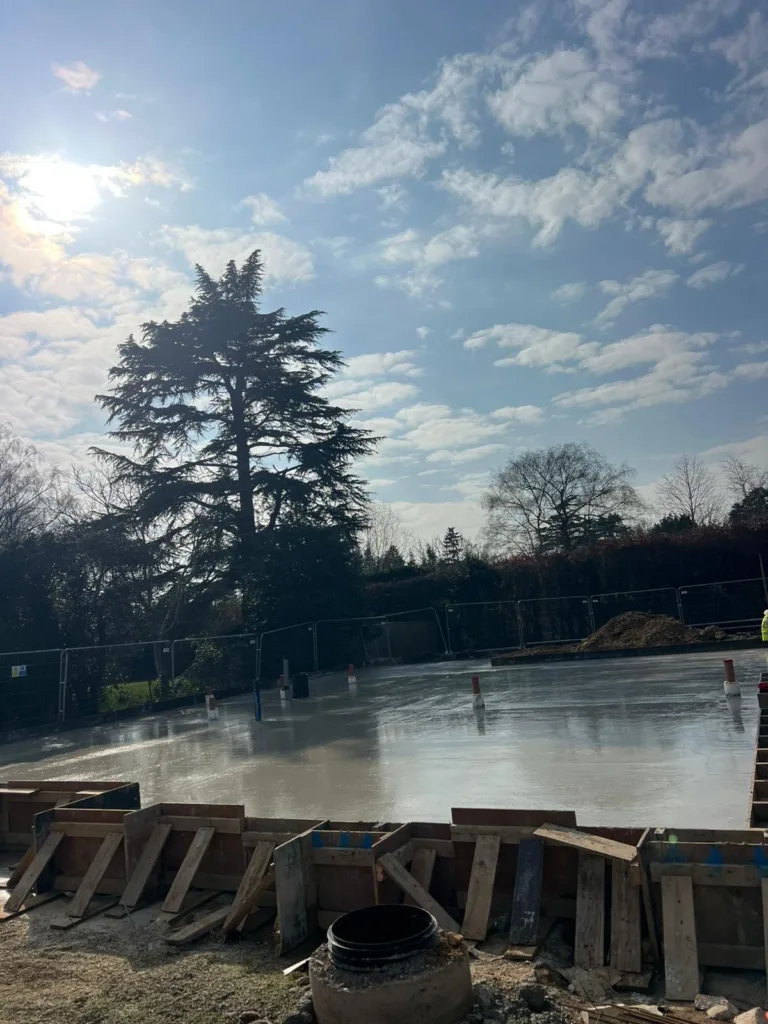

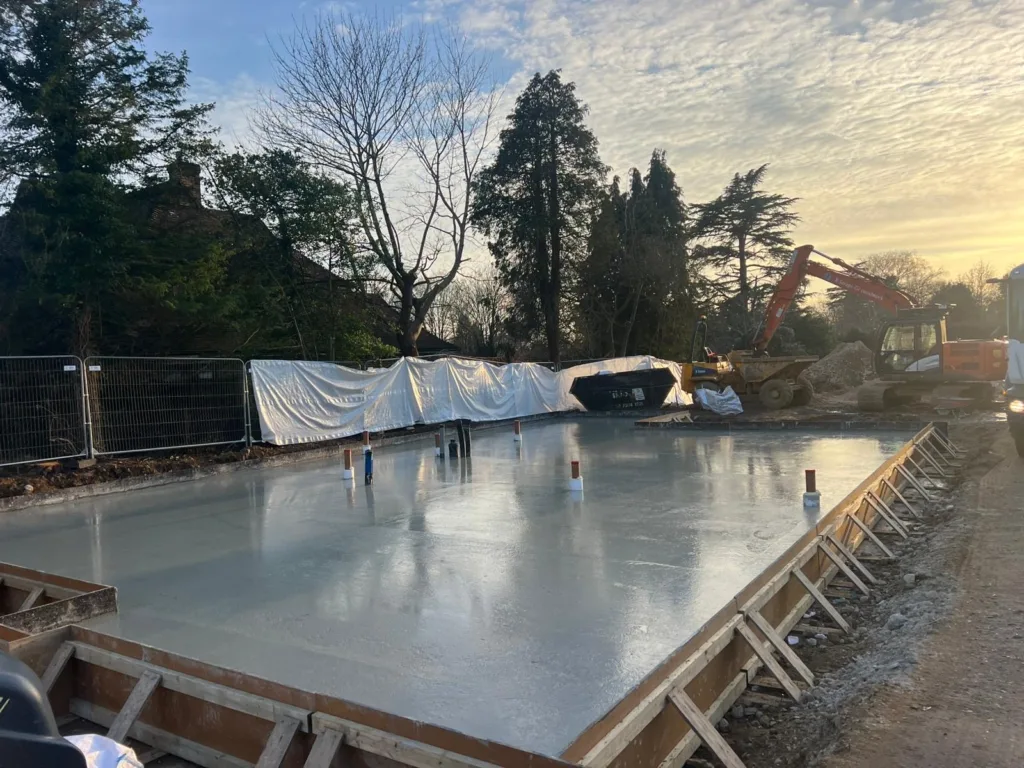

Concrete pour at Fairmile Lane Cobham
Concrete pour at Fairmile Lane Cobham 2

Construction

A concrete working platform, 922 m² in area, was laid before piling in place of a granular piling mat, giving the CFA rig a clean, stable base. SPEEDECK then installed the piles, the underslab drainage and services, the voidformer and approximately 19 tonnes of reinforcement, before pouring the rafts with around 178 m³ of concrete in a single pour. The work ran from the start of piling to handover at slab level in six weeks.

Project Conclusion

Mature trees, tree removals and shrinkable clay put every plot at Fairmile Lane at risk of heave. Voided piled rafts dealt with that risk without excavating more than 3 m deep, and kept the whole substructure under one design and build contract.

Heave protection: 160 mm voidformer under every raft, plus heave reinforcement in every pile

Trees: All 4 plots inside tree zones of influence, assessed to NHBC Standards Chapter 4.2

Excavation: No deep trench-fill; shallow foundations would have needed digs beyond 3 m

Piling mat: Replaced by a concrete working platform

Ground beams and pile caps: None

Programme: Six weeks from the start of piling to handover at slab level

Works were delivered on time and to a good standard.

James Thomson, Chartridge Developments Ltd
